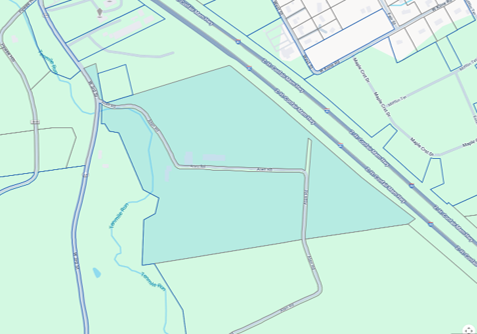

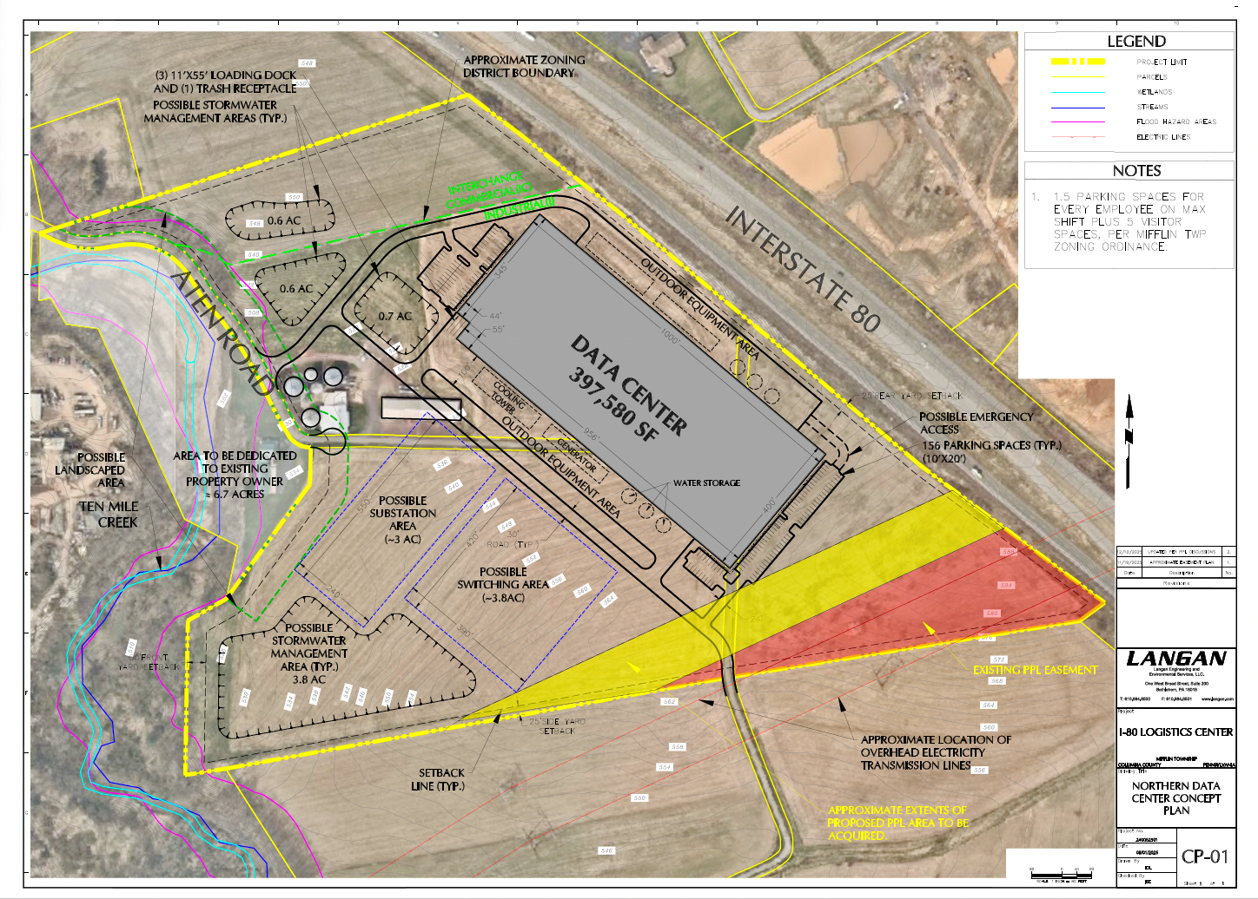

- 68 acres developable 75 miles northwest of Allentown, Pennsylvania
- Township recently passed Data Center zoning ordinance
- Project Feasibility Report (PFR) received from PPL for 180 MWs validating availability starting in 2029

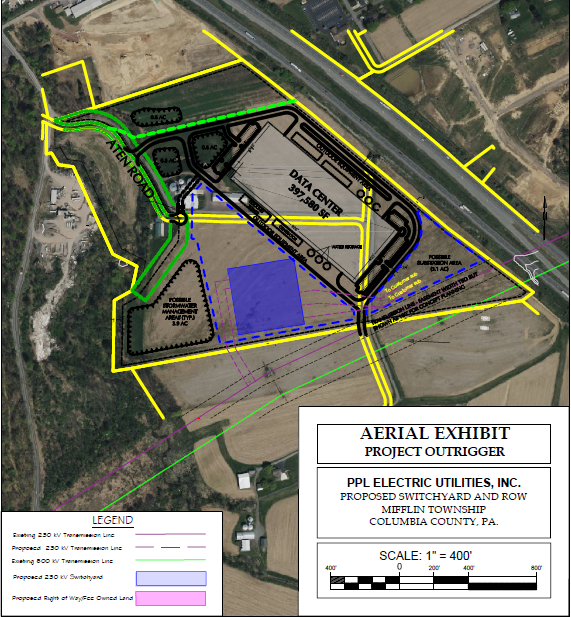

- PPA is in hand/signed and assignable by Outrigger
- Access to water and sewer
- Site is zoned industrial with data center as permitted
* PPL is looking at feasibility of adding some additional MWs based on infrastructure being installed on-site.
PPLEU Feasibility Schedule:
Agreement Schedule:
- Assuming Letter of Authorization (“LOA”) is signed by 7/27/2026:
- Initial project development will begin after a LOA is provided to PPL EU, along with a $350,000.00 downpayment, as well as proof of real estate ownership.
- Final detailed engineering will begin after the Electric Service Agreement (“ESA”) and Construction Service Agreement (“CSA”) are executed.
- PPL EU estimates 3-5 months to coordinate final ESA with the Customer
- Customer must sign ESA prior to December 23, 2026 to continue to proceed with proposed project schedule.
- PPL EU estimates 5-9 months to coordinate final CSA with the Customer.
Transmission Capacity Availability:
- Phase 1 (up to 180 MWs) – 32 to 42 months from LOA signature.
The Pennsylvania Advantage:
Business-Friendly Environment | Political Support | Economic Incentives
1. Computer Data Center Equipment Exemption Program
- Enacted in 2021, computer data center equipment is exempt from Pennsylvania sales and use tax when it is sold to, used, or consumed in a certified data center by an owner, operator or qualified tenant holding a Computer Data Center Sales and Use Tax Certificate of Exemption issued by the department.
2. Incentives from the OBB and State of Pennsylvania:
- H.R.1 – One Big Beautiful Bill Act: 100% depreciation in Year 1 of new plant.
